|
Summer
2001 Monica took most of these over a couple of our 4-day weekends on the site.
It took so long to bring in the machinery, that we scheduled Thursday
through Sunday or Saturday through Tuesday 'weekends'. Many folks
showed up for multiple days at a time, camping overnight to avoid the
'commute'. Those who could arrange for weekdays, did -- and we thank
you.
|
|
The

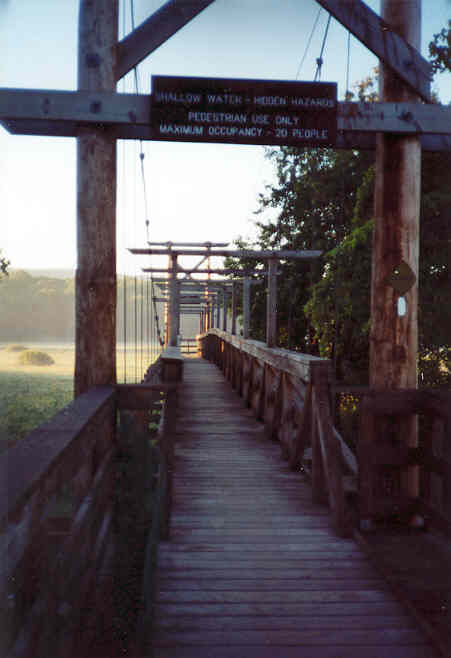

centerpiece of this project is 'the bridge'. This was built in 1996
to cross the river. I call it a 'flying Adirondack bridge'. It
looks and is built very much like one of the classic bridges, except that
it is 20' in the air on large steel cables and telephone poles.
There is a staircase up from the ground level at each end, which connect
into the boardwalk and trail system.
(
Currently, the Trail Conference's website has some of the best pictures of
the bridge, but I will try to get some more detailed ones, soon. )
|
|

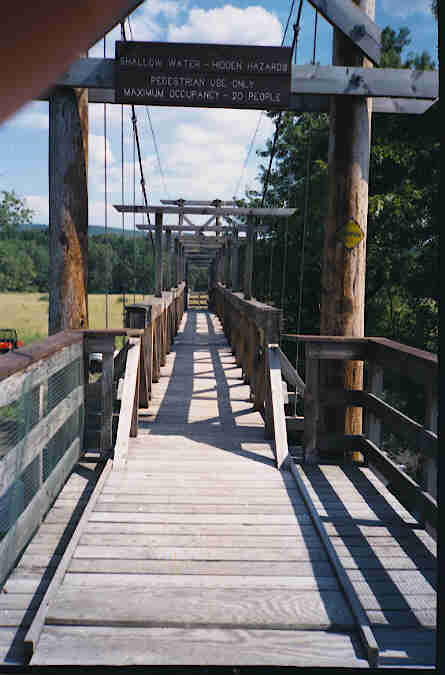

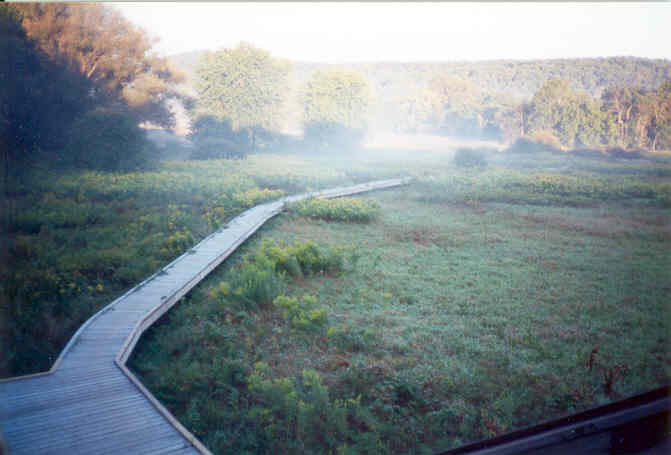

A
view from the bridge. Looking west along the river bed. This
looks all quite peaceful and innocent at this point in a very hot, dry,
late summer. But when the spring melt waters and the April showers
get together (and the occasional hurricane) this quiet little stream
becomes quite the roaring flood water. I am told there is some
pretty good fishing to be done here, as well. |
|

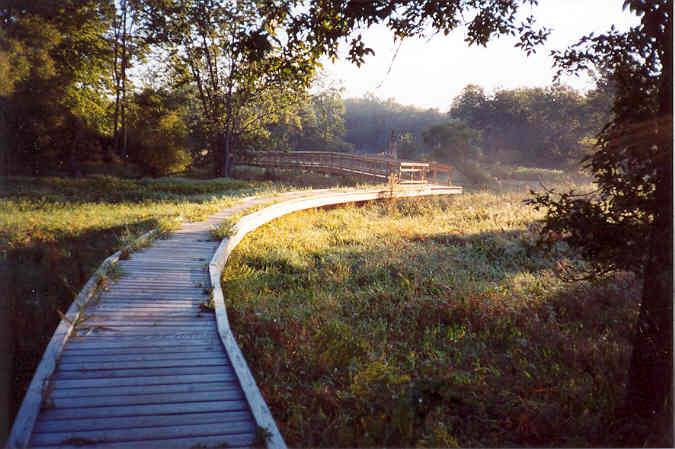

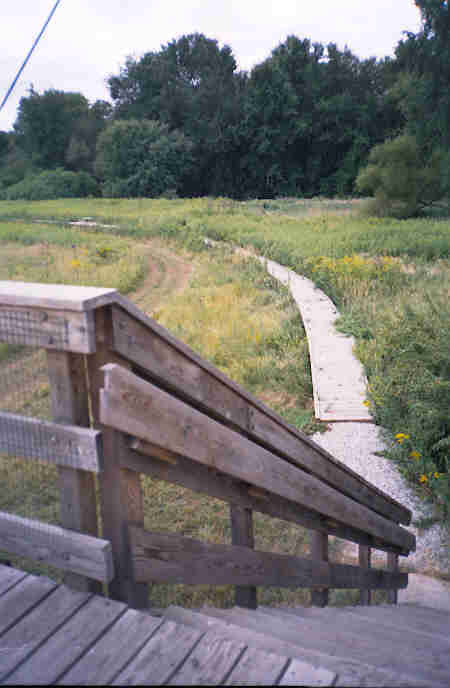

At
each end of the bridge, a staircase drops down to the trail. Here is
the north end stair, which drops to a short gravel pathway which then
ramps up to the boardwalk's design altitude. Yes, altitude.
The engineer's drawings specify the boardwalk decking as being above the
'record flood' level of around 394' above sea level. This level is
followed throughout the project. When the ground pops up onto an
'island', the boardwalk transitions into conventional trail. Then,
when the ground falls away again, the boardwalk re-starts.
All-in-all there is about 500' of conventional trail, and nearly 2/3
mile of boardwalk.[photo: Monica Resor] |
|

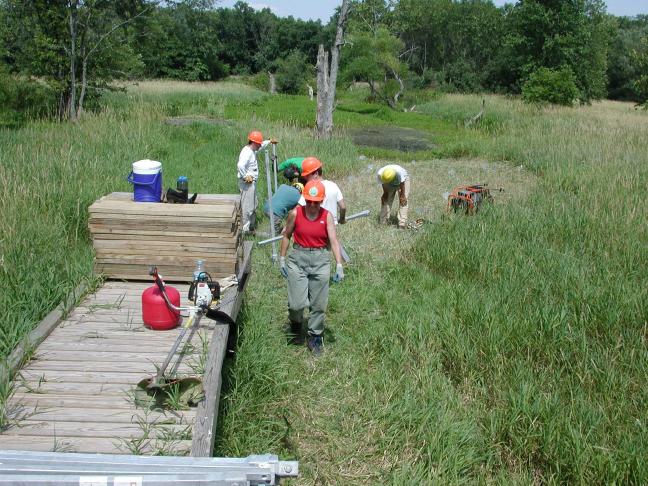

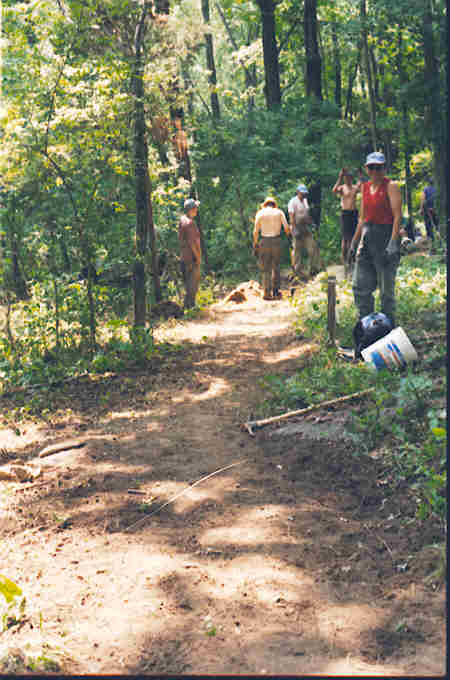

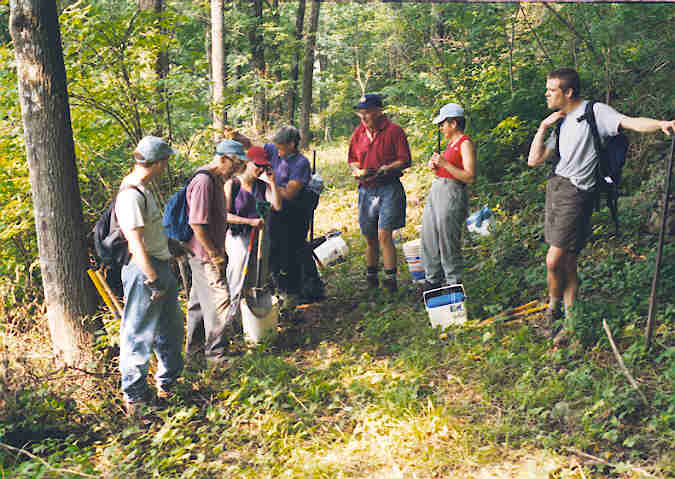

Here

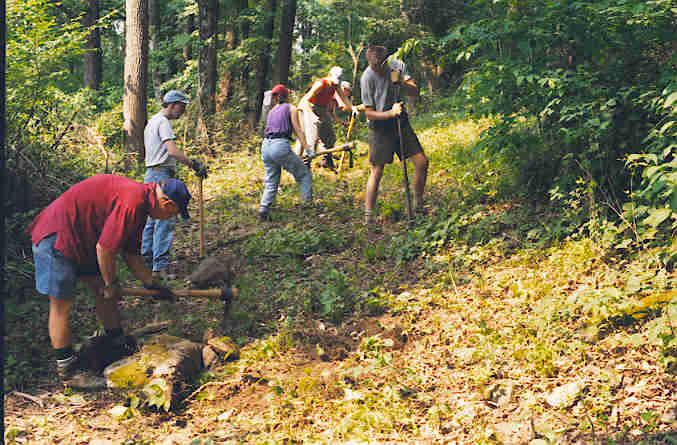

the NY/NJ TC West Jersey crew is poised for action. Our first trip's
assignment was to do this section of conventional trail that has been
marked out. This will need to be cleared, leveled and reinforced for
all of it's over 500' run. There are many large outcrops of rock
which will need to be negotiated on the way. [photo: Larry Wheelock] |
|

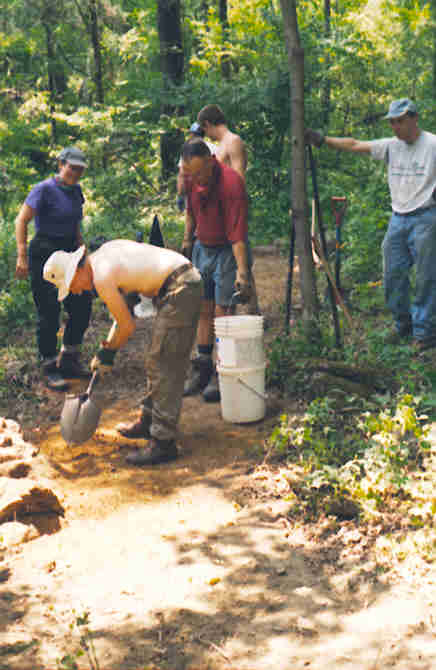

Here

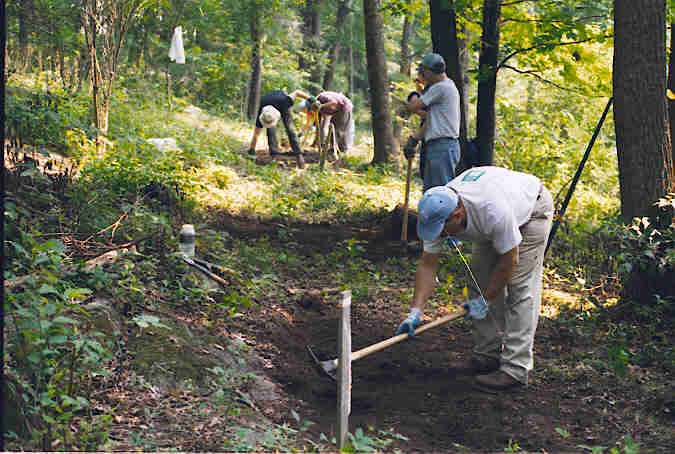

is a typical view of the process. The crew members will spread out
along the flagged route, each staking out a section to work on. This
is much safer, since there is much less chance of anybody getting hit by
accident. Once each person's section is completed, they will
leap-frog down the line to the next spot. [photo: Larry Wheelock] |
|
Here
is another view of the process a little further along. The stake in
the foreground marks the point where the end of the boardwalk will taper
into the ground, transitioning the hiker onto our conventional trail.
[photo: Larry Wheelock] |
|
The
crew at work. As sometimes happens on any 'road crew', one person is
digging while others are toting rocks and dirt either away from, or to,
the digger. [photo: Larry Wheelock] |
|
We
are getting pretty close to done, here. Monica is stopping for a
breath and a drink, while the rest of the crew moves down to the far end
to wrap up. It was nearly 90° that day with humidity over
90%. This crew is dedicated! [photo: Larry Wheelock] |
|

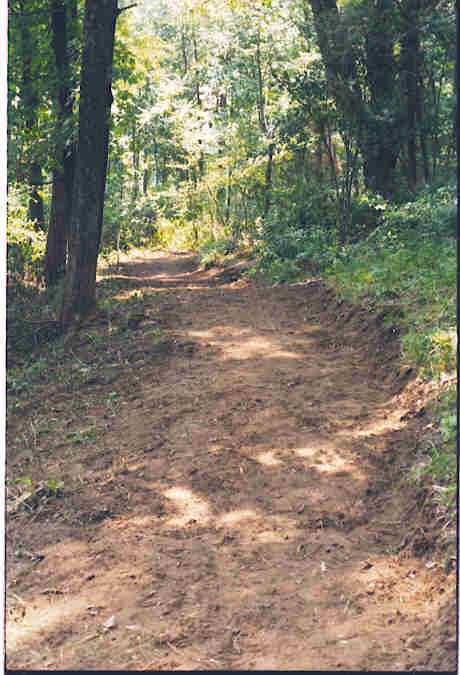

And
here is the finished 'conventional' trail section. Next trip will be
the boardwalk. [photo: Larry Wheelock] |
|

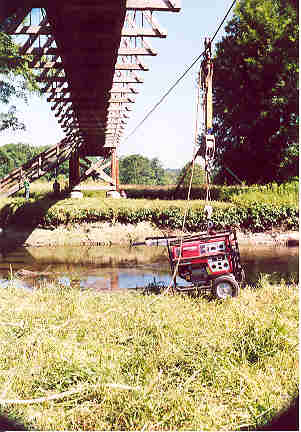

At
the start of the boardwalk work trips, all
the equipment, tools and machinery were brought in from the north end of
the project. A steel highline was set up under the bridge, using the
bridge structure as endpoints. From that, we could suspend things
like this 5000w generator, a hydraulic pump, the hydraulic auger driver,
power tools, gas tanks, etc.. Then, they could just be 'floated'
across the riverbed to the bank 50' away. Take

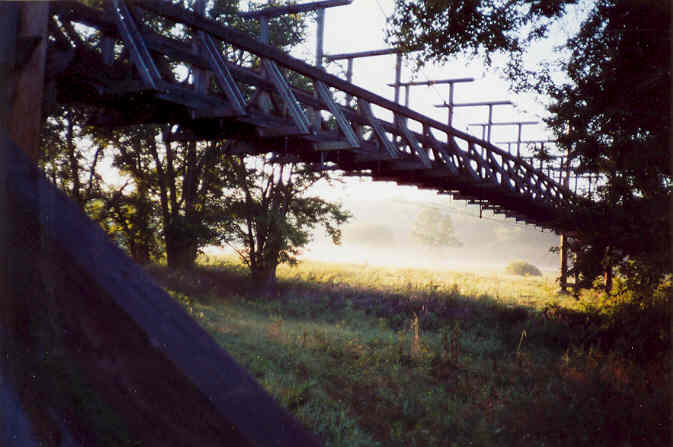

a look at the underside of the bridge! What a beautiful piece of
work this was. Wes Powers (NJDEP Regional Maintenance Coordinator)
is the project 'boss' and saw this through to completion (I think) as a
personal 'mission'. He had help from the utility company that
supplied and installed the poles; but most all of the rest was done by old
fashioned smart manpower!
|
|

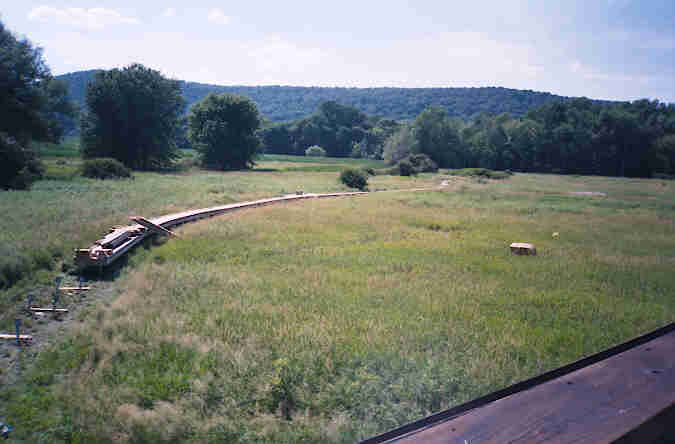

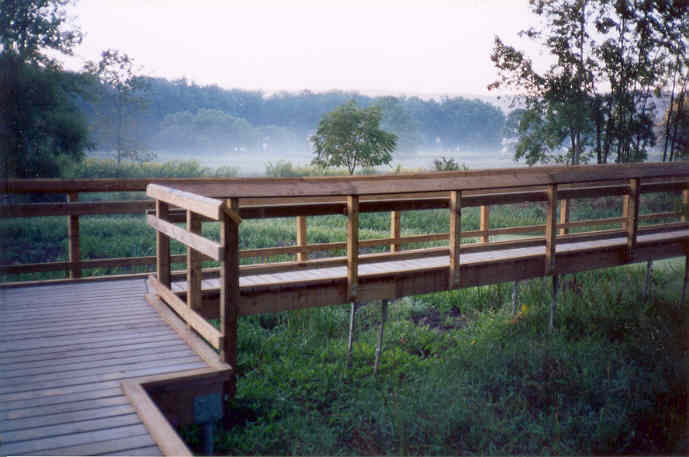

This
is a view from the south end of the suspension bridge which crosses the
Pochuck River about a third of the way from the north end of the wetlands
area. From this point, there is probably about 3/5 of a mile to go,
until the trail gets out to the road crossing. To the right of the
boardwalk is the area where much of this year's materials were air-lifted
in by the Forestry Service.
|
|

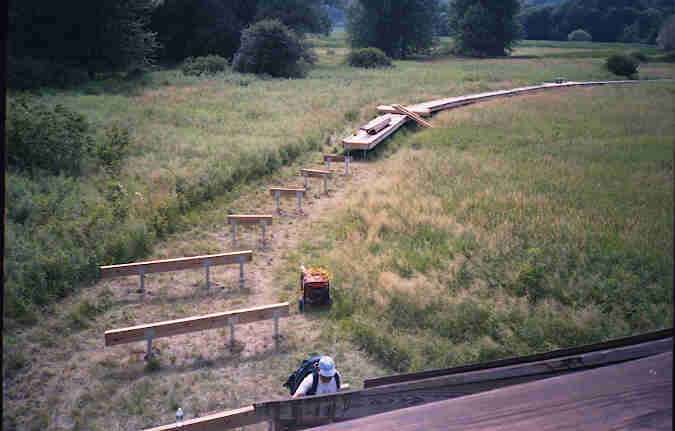

From

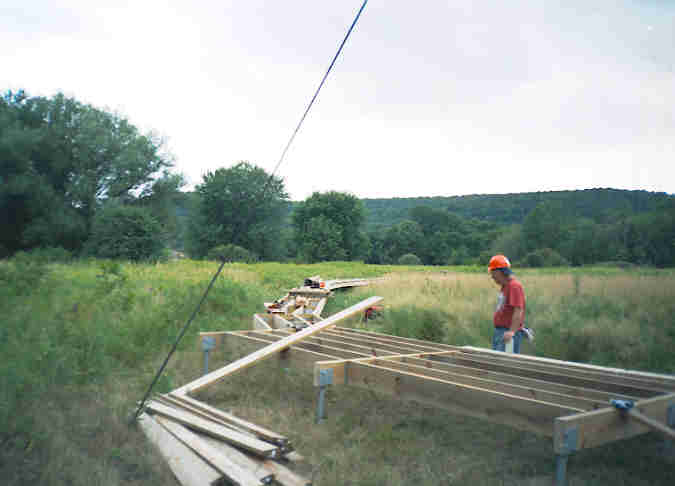

the bridge, looking south. This was our (West Jersey crew) first
part to work on. This last 100' or so had to be completed and
brought up to, and connected with, the bridge's south end staircase.

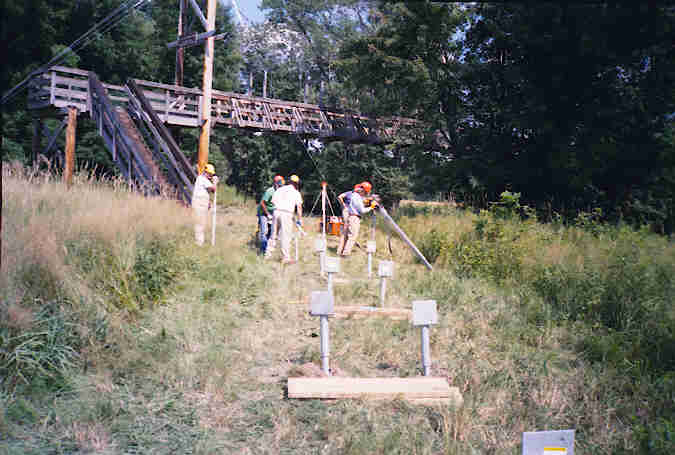

Here we are beginning to lay out the positions for the pilings. We
also had to carry the materials from out in the field (to the right) where
they had been air-lifted and dropped off. 'The Ants Go Marching Two
by Two'...... |
|

The
pilings (one is laying down across the bottom of the frame) are large
augers on a 6' steel bar. The bar is 1.5" square and weighs
about 60 pounds. The hydraulic driver is actually a slow, immensely
powerful drill. It sits on the top of a piling shaft with a socket,
and drives the auger into the ground. 5' extensions are bolted on as
needed to drive the auger down until the design-specified conditions are
met. |
|

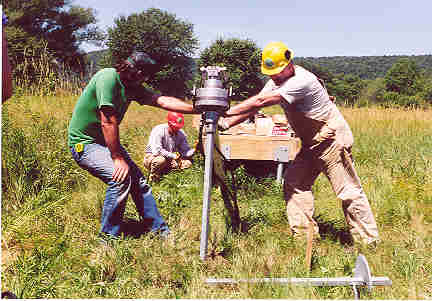

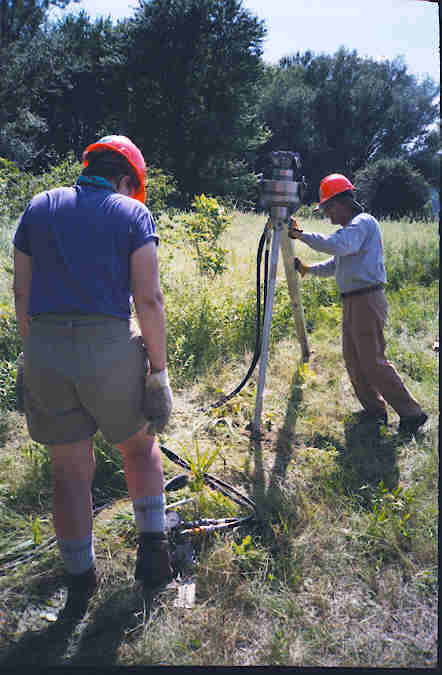

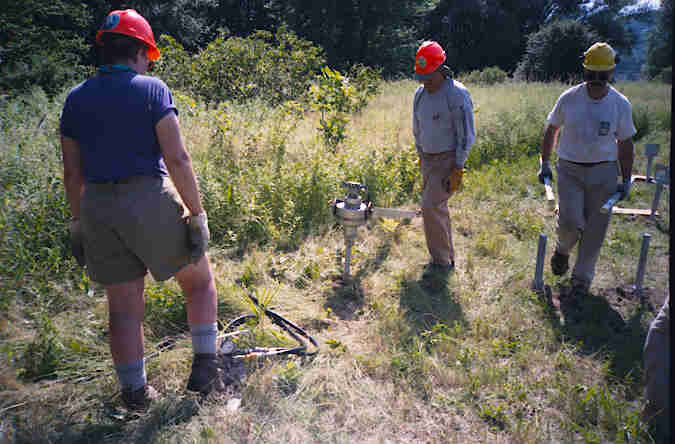

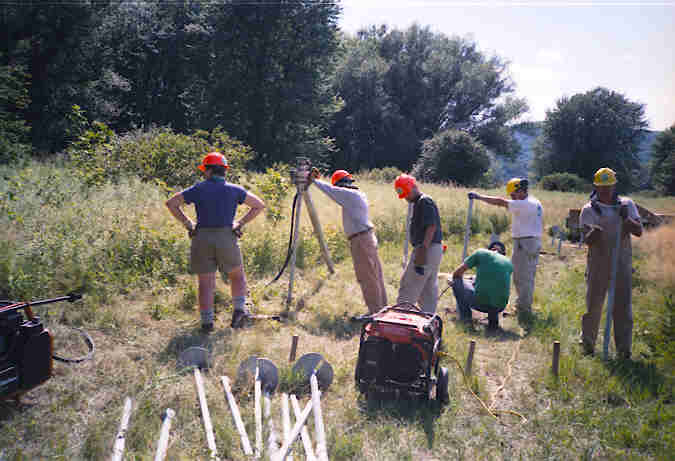

With
foot-operated hydraulic valves, the drill is run forward and back.
One or more persons steady the drill head in place. The head takes
about 3 strong, tall persons to place it -- it is very heavy! It has
a 'tail', which you can see, which is chained to a prior piling to prevent
the drill head from turning, rather than the auger. The design
target criteria is for 800 foot-pounds of rotational torque; there is no
way that people could hold it. At that point, the engineers have
determined that the piling is into a firm, secure strata below the level
of the swamp. Some of them were driven as deeply as 24 feet. |
|
As
the pilings are driven in, the rest of the team begins staging more of the
materials from the fly-in zone. Wes Powers (that's him in the green
DEP shirt) is also using his infra-red surveying system to determine the
level to cut off the excess piling at. |
|

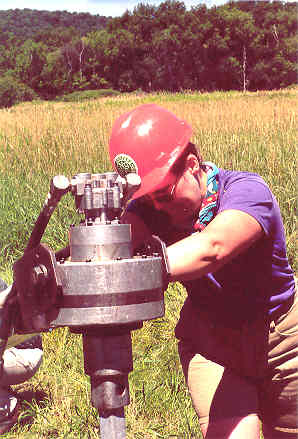

Here
is a close-up of the job of wrestling with the drill head. We worked
in rotating teams of 3-4 people to try to keep the drill going as close to
full time as possible. As the pilings were screwed into the ground,
they would hit the odd stone (or mountain top) and the whole thing would
go off of vertical. Not that any person could stop it, all you could
do would be to try to lean it back up as close to vertical as it would
go. Not only was this drill head heavy, it got
quite hot after awhile; so it was quite the tough competitor.
Mary-Nell, here, was absolutely up to the task. |
|
Once
a piling was driven to the desired torque point, you were done. If
you fell below the correct altitude, though, you would have to add an
extension and drive it in until the joint was below the ground. This
one will need another length. |
|
After
the piling is set and the desired height marked, a portable band saw is
used to cut off the extra piling bar stock. Oh, what a difference
having the right tools makes! |
|
After
the piling is cut to height, a saddle piece attached to a sleeve is
dropped over the top of the exposed end. This saddle will hold a
doubled up pair of 2x10's as a beam. The beams are bolted to and

through the U-shaped saddles in preparation for the joists. |
|

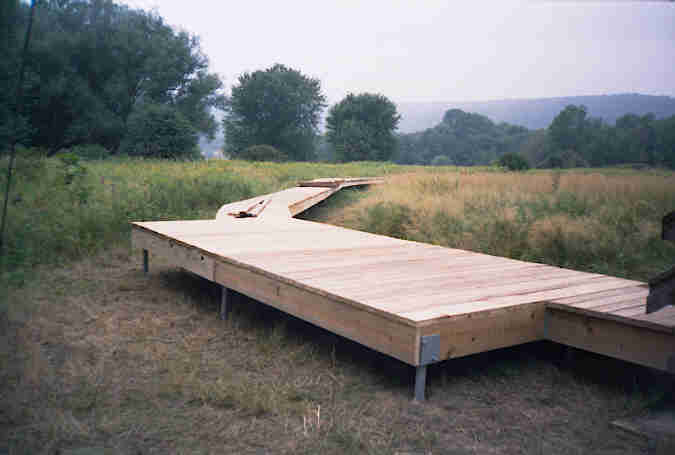

Here
you see a number of finished beams ready for the joists. Most of the
beams are 4' long, but the ones closest to you in this picture are 8'
long. They are for one of the periodic turnouts, or passing areas,
along the course of the boardwalk. |
|

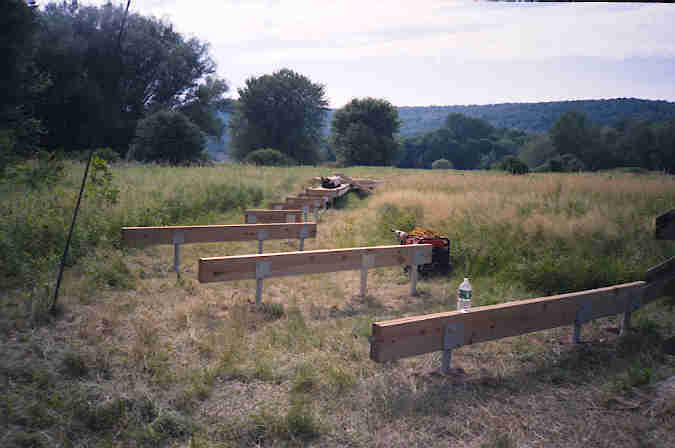

At
the end of the day, the pilings are all in place for this section, and the
beams are ready for the joists. The beams are 10' apart. |
|

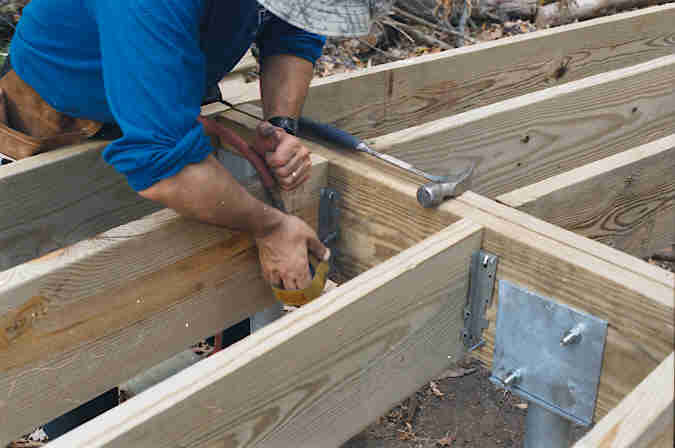

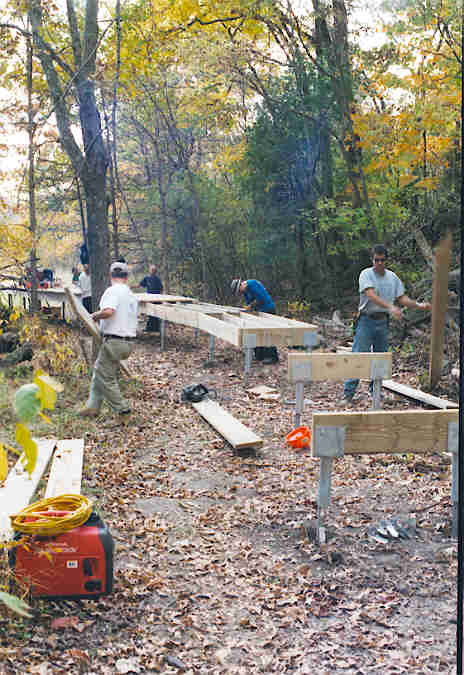

Conventional
joist hangers are used to place the joists on the beams. Each joist
has to be custom cut because (let's face it) the dimensions between the
beams are 'variable'. Also, the boardwalk curves and bends as it
goes, so the framework has to be cut to make that happen in the structure,
also. |
|

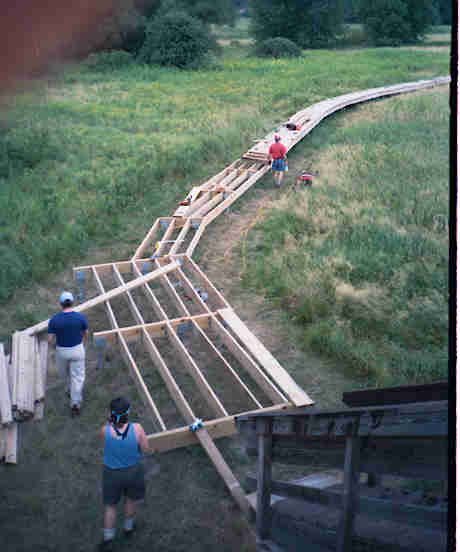

Here
you can see the framework taking shape. This is from the south end
of the bridge, and the wide, passing area is just before the connection to
the bridge's staircase (not yet in place). |
|
Once
the framework is completed, the decking can be put down. The deck
boards are placed 1/2" apart, then minimally nailed down. Where
the deck has to bend, the boards are cut long-ways into a series of wedges
which form a kind of 'fan' pattern, which follows the curve of the
pathway. Once all the decking has been placed and tacked in place,
each deck board is then drilled and screwed twice into each beam
crossing. After driving the pilings, the drilling and screw driving
were the most grueling tasks. Not that they were so difficult, but
they required you to work either on your knees or bent from the waist to
work the drill and screw-gun. |
|
And
here it is! The connector to the bridge staircase is in place and
all the decking is down. All that remains in this section is the 2x3
'curbing' which will be placed at the edge and screwed down.[photo: Monica Resor] |
|
Autumn
2001 The Appalachian Trail
Conference's Mid-Atlantic was working on the site for several weeks in September and
early October. There have also been visits from the regular
volunteers, and a field trip by the professional carpenters union
local. |
|

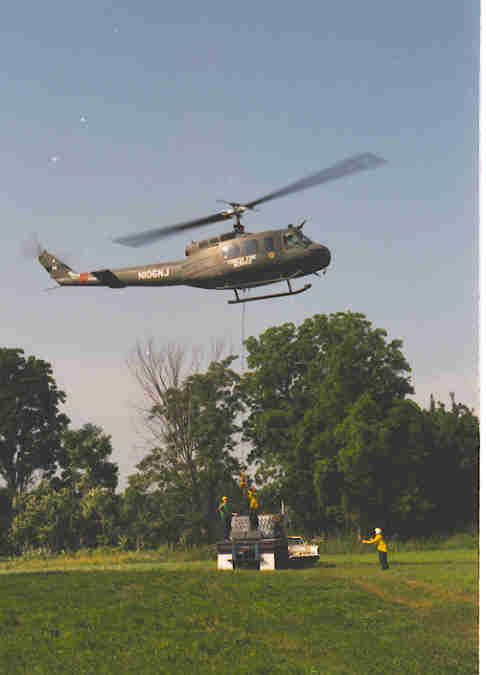

Before
the work could begin, materials had to be brought in. Once again,
the Fire Service provided the air-power to bring in the tons and tons of
material. In prior seasons, the materials were trucked to the end of
the boardwalk and hand carried the half mile or so to the work area.
This was a vast improvement over that use of person power! We
still had to carry the materials around, but nowhere nearly as far.
A great improvement in productivity! Thanks again guys!!!
[photo: Larry Wheelock] |
|
Throughout
the Fall work season, the majority of the balance of pilings were screwed
into the ground and the framing and decking placed. Here, some of
the Builder's Association crew is putting in more of the joists and
stringers. |
|
Here
is a close-up look at what is going on underneath the decking. You
can see the metal joist hangers - just like the ones used in your
modern-day house construction. All this is covered over with 2x6
deck boards, which form the actual boardwalk surface. |
|

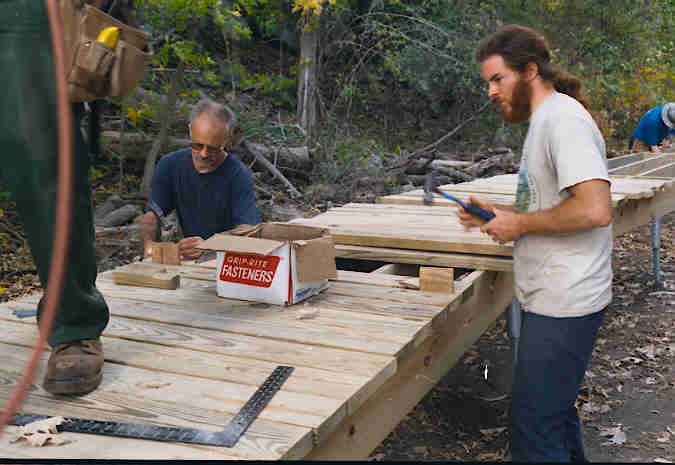

These
fellows are a couple of the ATC crew working on placing the decking once
the under structure had been completed. Each deck board was tacked
into place with a couple of nails. Half inch spaces between the
boards will permit water to flow through, preventing puddles and slowing
down the rotting of the deck. |
|

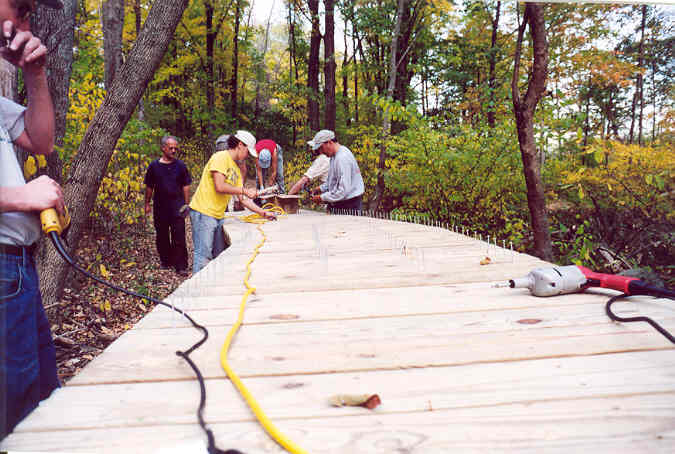

The
final step to securing the decking was to screw it down to the beams
underneath. The screws were 4inch galvanized construction screws, 2
per deck board on all 4 beams. Pilot holes had to be drilled, then
the screws tapped into the holes to start them. |
|

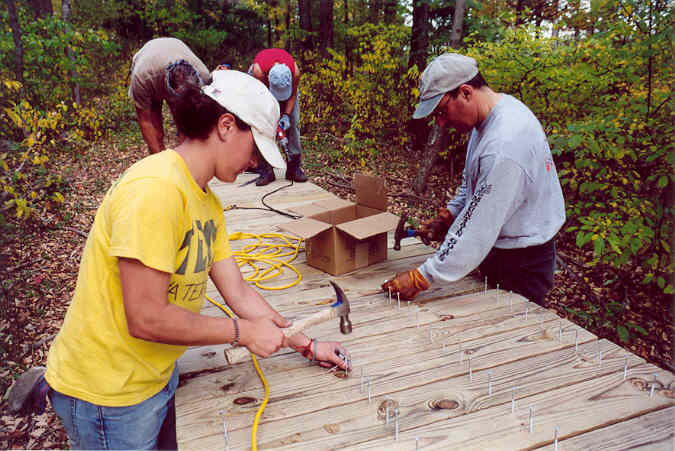

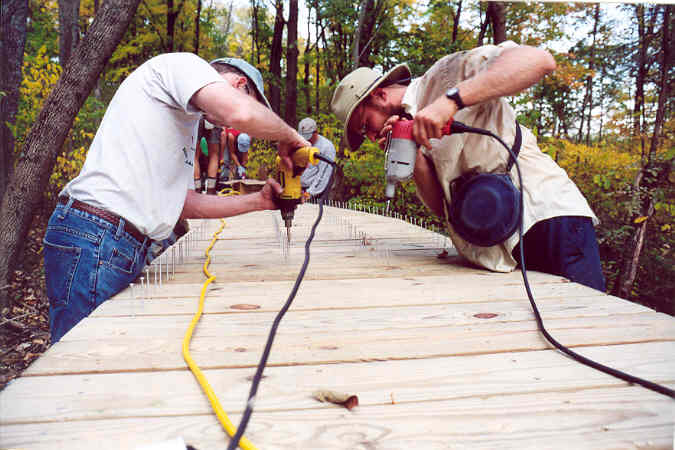

Here
you can see the 4 rows of screws. Monica (red shirt) and others are
leading the parade, drilling the pilot holes. Norm (grey shirt) and
a member of the ATC crew are setting the screws. |
|
And
here is the final step. Jack (left) and a member of the NY/NJ TC
North Jersey Crew are driving the screws using power screwdrivers.
At a typical rate of 16 screws per foot of decking, multiplied by the
roughly 3000 feet of boardwalk, that's 48,000 pilot holes and screws! |
|
Once
the decking is secured, 2x3 'curbing' is screwed down to finish the
job. The curbing defines the edge, helping to prevent folks from

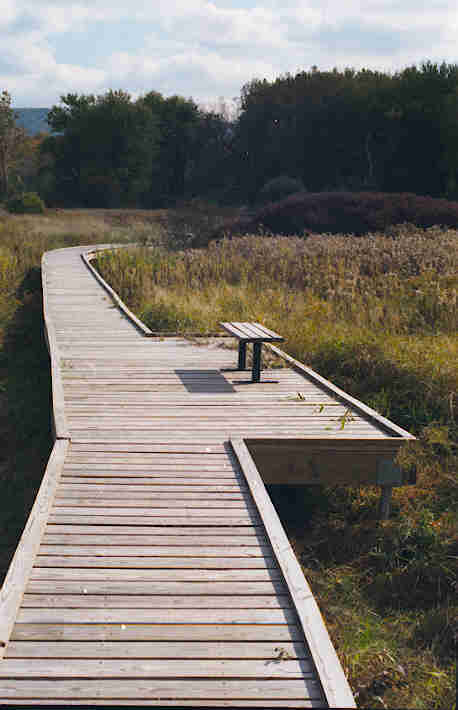

wandering off the edge. The turnouts, like this one, provide a
wonderful place to sit and watch the many birds and other wildlife. |
|
The
entire southern end of the boardwalk passes through an amazing forest of
cattails. These are about to release their 'puffs', carrying their
seeds far and wide. |
|
Spring
& Summer 2002 Once again, into the
fray. This time, there's a deadline... the opening ceremony is
scheduled!!!
This
season is about finishing up the final deck sections, creating ramps to
transition from the boardwalk down to the conventional treadway.
Once completed, the
"farmer's bridge" will also require a full railing, since it is
quite high above the ground and water where it crosses the
channel.
The
NY/NJ Trail Conference's West Jersey and North Jersey crews, along with
folks from the ATC and The NJ Builder's Association worked many, many
weekends throughout the year. Everybody was pushing for the
conclusion of nearly 20 year's planning and work.
|
|
Once
again, the first step is always getting the materials and tools to the

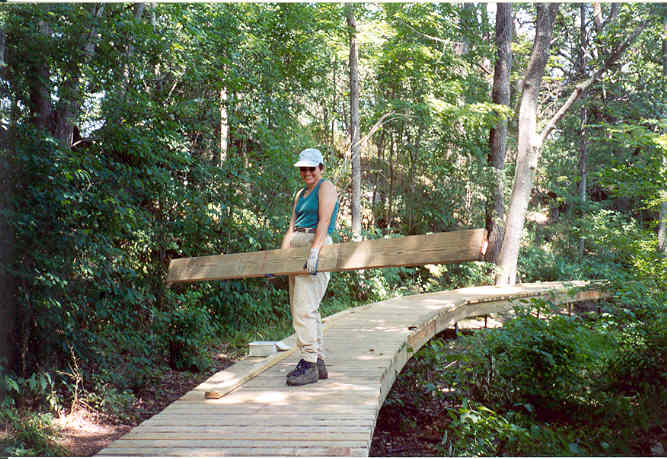

site. Here, Monica poses with one of the roughly 1600 joists.
Everybody who worked on this project -- top to bottom -- did 'tote duty'
at one time or another. At times, the strains of "the ants
go marching two by two..." could be heard drifting across the
bog.
|
|
Truth
be told, we didn't hand carry all the lumber and materials, or we'd still
be on the first sections. Wherever the materials were dropped (air
lift or dump truck), they were hand carried to however much of the
boardwalk was passable, and then loaded onto hand trucks and
dollies. These were then wheeled as close as possible to where the

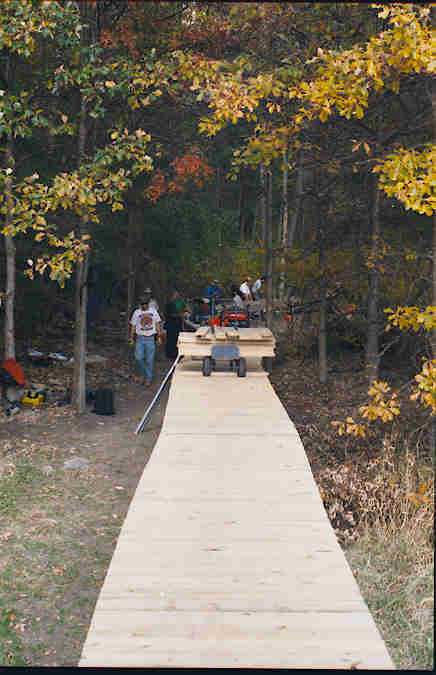

load could be used. Here, a load of lumber is headed into the woods,
having been brought about 1/3 mile from the southern end. |
|

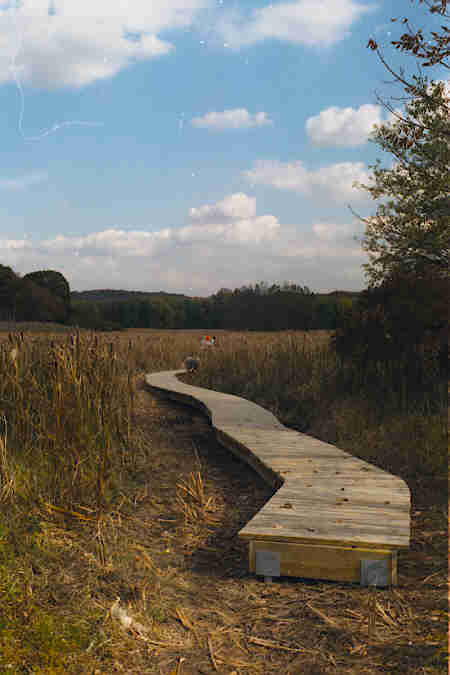

This
is where we left off at the southern end of the boardwalk last fall.
This will need to be extended another 400-500 feet to meet the road-side
trail access. This photo was taken before the wildfire that ravaged
the dried cattails and swamp grasses in the early spring (which delayed
our getting started by a week or so). |
|
This
is the area where there used to be a farmer's bridge over a side channel
of the local waters. Here you see the piers which are ramping up
from the south to where the actual bridge structure will be
installed. The water looks low in this picture, but remember we have
been in the middle of a multi-year drought! |
|
Here
the boardwalk approaches the location of the farmer's bridge from the
north. You can see the height of the deck compared to Monica
standing next to the end. This is about where it begins to ramp up
to the actual bridge structure. We were very fortunate throughout
this project to be "blessed" with dry conditions -- otherwise
Monica would be knee-deep in mud and the deck would be at her shoulders. |
|

On
May 5th, 2002 the final pier was driven. Here is the crew doing the
honors in Larry Wheelock's photo. |
|

This
is the "Farmer's Bridge". Since the bridge is so far above

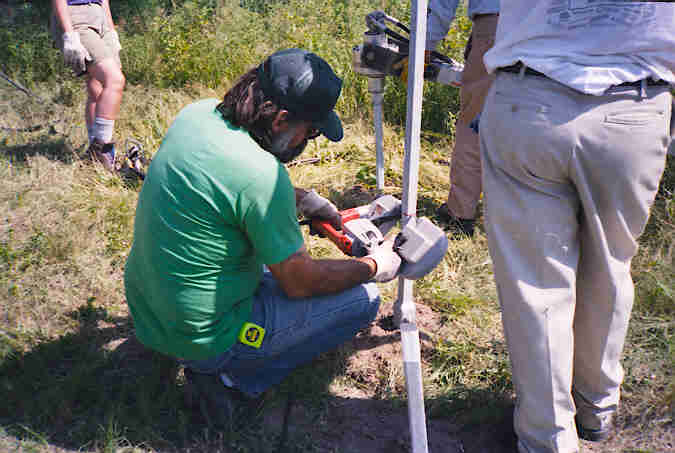

the ground and water, a handrail is required. Here you see Wes
Powers (green shirt) and some of the others fabricating the railings onto
the bridge structure. Note how high the grasses are -- the boardwalk
is actually about 7 feet in the air below where Wes is standing! |
|
Nice
bridge! That's
David on the southern end, checking out the bog turtles at sunrise on one
of the summer 'double-header' weekends. We camped on-site to
monitor the equipment, to avoid loosing the time needed to move it all in
to the worksite every morning. It could take as long as a half hour
per round trip from the vehicles -- you'd loose half a day's time, just
getting ready to work. [photo: Monica Resor]
|
|

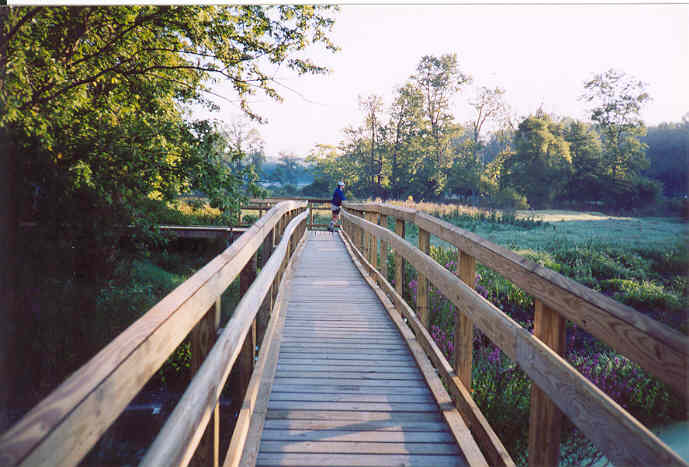

The
finished bridge, from the southern end, with the morning mists across the
swampland meadows lifting behind. [photo: Monica Resor] |
|

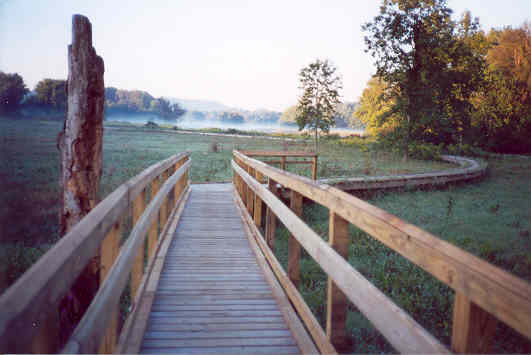

On
the farmer's bridge, looking northbound toward the suspension bridge about
half a mile ahead. The morning mists hid the larger bridge from our
view. The swamp is a magical place at sunrise... [photo: Monica Resor] |
|
Looking southbound at the northern end of the farmer's bridge. See how quickly the swamp retakes it's own. This section of boardwalk was put in less than a year before, and has already been weed-whacked once to keep it open. Once the drought is over and things really begin to grow, the walkway will require regular 'mowing' to keep it from disappearing altogether! [photo: Monica Resor] |
|
Looking back toward the farmer's bridge from the southern end of the suspension bridge. Shortly before Monica took this picture, we were treated to a visit by a juvenile red-tailed hawk. He had been hanging around while we worked at the farmer's bridge area -- allowing us to watch him practice his hunting skills. Believe me, from 10 feet away, he was one intimidating bird! [photo: Monica Resor] |
|
Morning is a magic time in the Pochuck wetlands. If you can get there, go! [photo: Monica Resor] |
|
The Pochuck River Appalachian Trail relocation was the reportedly the largest single construction project (yet) on the AT. It was declared open at a gala on October 20, 2002. In attendance were crew members, dignitaries, and one of the local black bears. The boardwalk is a means for us to walk through a magical world of herons, hawks, eagles, turtles, red-winged blackbirds and the other creatures which inhabit the wetlands. The wetlands themselves are a wonderland for those of us who want to see what some of New Jersey might have looked like when the bears and eagles were in control. [photo: Monica Resor]
Please -- if you have the opportunity to do so, come to this amazing place; and if you can, spend some time at dawn or dusk and let the swamp work it's magic on you! |
